Linear programming solution by steps for two-phase method, Operation Research

Assignment Help:

Solve by Steps for Two-Phase Method

Max Z = 5x1 + 8x2

Subject to

3x1 + 2x2 ≥ 3

x1 + 4x2 ≥ 4

x1 + x2 ≤ 5

    &     x1 ≥ 0, x≥ 0

Answer

Standard LPP



Max Z = 5x1 + 8x2

    Subject to

                        3x1 + 2x2 - s1+ a1 = 3

                        x1 + 4x2 - s2+ a2  = 4

                        x1 + x2 + s3 = 5

                        x1 , x2 , s1, s2, s3, a1, a≥ 0

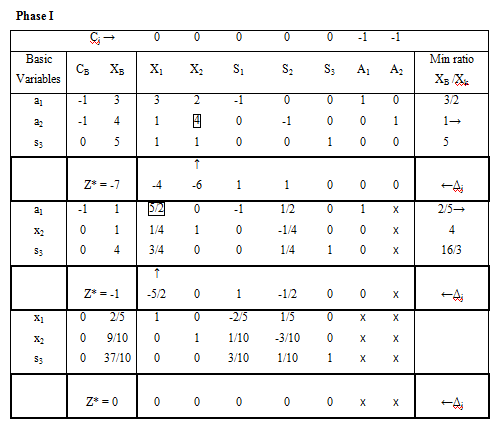

Auxiliary LPP

Max Z* = 0x1 + 0x2 + 0s1 + 0s2 + 0s3 -1a1 -1a2

    Subject to

                        3x1 + 2x2 - s1+ a1 = 3

                        x1 + 4x2 - s2+ a2  = 4

                        x1 + x2 + s3 = 5

                        x1 , x2 , s1, s2, s3, a1, a≥ 0




As all Δj ≥ 0, Max Z* = 0 and no artificial vector appears in the basis, we move to phase II.

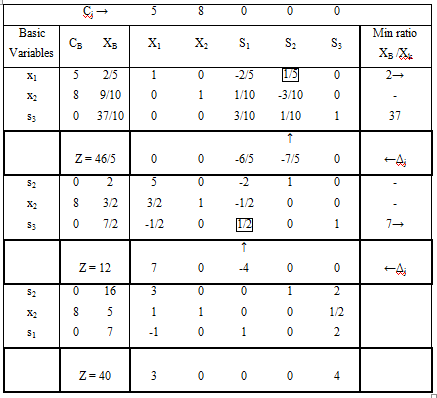

Phase II


As all Δj ≥ 0, optimal basic feasible solution is achieved. Thus the solution is Max Z = 40, x1 = 0, x2 = 5
