Calculate the elapsed time of the critical path project, Project Management

Assignment Help:

Calculate the elapsed time of the critical path project when

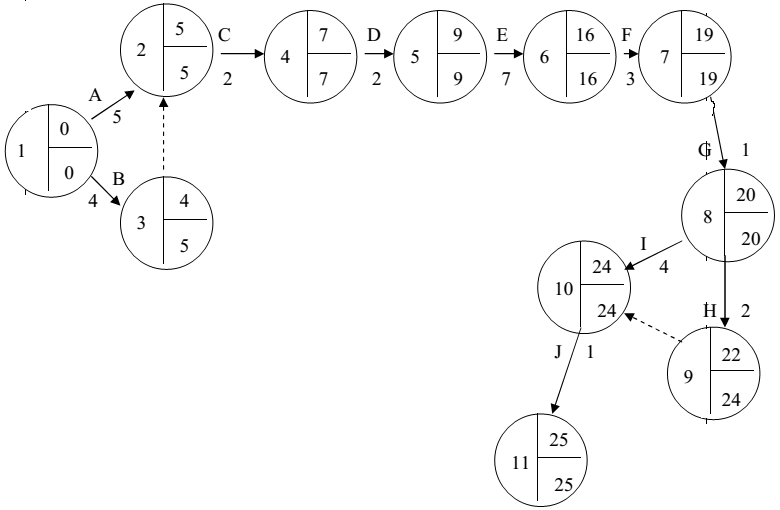

A Critical path of ACDEFGIJ is given below and the elapsed time of the project is 25 weeks.

There H can over running by 2 weeks without affecting the elapsed time of this project.



1006_Calculate the elapsed time of the critical path project.png


Related Discussions:- Calculate the elapsed time of the critical path project

What is buffering in risk management, What is Buffering in risk management?...

What is Buffering in risk management? Buffering: Buffering or slack is the allowance of additional cost, resources or time for example ‘just in case’ specific events or r

Implementation of a quality program, Question: (a) Any project has a be...

Question: (a) Any project has a beginning and an end; without a formal closure process, project teams can fail to recognize the end and this can drag the project into unnecessa

Effect of the organisational values in individual behavior, The individual ...

The individual is a central feature of organisational behavior and a necessary part of any behavioral situation. According to the study findings, that organisational value has help

Concept of values to an organization, The Buddha had said that an individua...

The Buddha had said that an individual is free to think and decide on his own and at the same time he is responsible for his own actions. Organisations are about individuals; they

What types of errors disclosed in trial balance, What types of errors discl...

What types of errors disclosed in Trial Balance? A Trial Balance discloses the given types of errors as illustrated follows: a. An item posted two times. b. A mistake int

Electronic document delivery systems, Electronic Document Delivery Systems:...

Electronic Document Delivery Systems: The systems employing electronic technology for the receipt of requests and supply of documents are known as Electronic Document Delivery

Managing information system, Laudon & Laudon''s Four-Step Problem-Solving &...

Laudon & Laudon''s Four-Step Problem-Solving & IS-Building Model and/or the Integrated Framework for Describing and Analyzing Information Systems to:  investigate persisting busin

Can surprises be reduced, Q. Can surprises be reduced? Yes absolutely! ...

Q. Can surprises be reduced? Yes absolutely! By their vary nature projects are uncertain business and uncertainty can lead to both risk and opportunities. As a result a very im

Degree of vertical integration, Degree of Vertical Integration Vertical ...

Degree of Vertical Integration Vertical integration is the amount of production and distribution chain, from suppliers of raw materials and components to the delivery of finishe

Concepts of market size, When JF persuaded a leading retail supermarket cha...

When JF persuaded a leading retail supermarket chain to trial her 'home-made' chocolate dessert range she could not have anticipated how well it would sell. Now a year on she has f

Write Your Message!

Captcha
Free Assignment Quote

Assured A++ Grade

Get guaranteed satisfaction & time on delivery in every assignment order you paid with us! We ensure premium quality solution document along with free turntin report!

All rights reserved! Copyrights ©2019-2020 ExpertsMind IT Educational Pvt Ltd
